Our pass rate is high to 98.9% and the similarity percentage between our PRINCE2-Practitioner study guide and real exam is 90% based on our seven-year educating experience. Do you want achievements in the PRINCE2-Exams PRINCE2-Practitioner exam in just one try? I am currently studying for the PRINCE2-Exams PRINCE2-Practitioner exam. Latest PRINCE2-Exams PRINCE2-Practitioner Test exam practice questions and answers, Try PRINCE2-Exams PRINCE2-Practitioner Brain Dumps First.

Check PRINCE2-Practitioner free dumps before getting the full version:

NEW QUESTION 1

Additional Information
Chief Executive Officer (CEO): He started the company 25 years ago and knows his job very well. He injured his leg two years ago which has restricted his visits to the engineering area. As CEO he has an overall perspective of the business strategic requirements and the authority to commit resources as required.
Marketing Director: She has been with the company for three years, following a successful career with a publicity company. She has the ability to represent the needs of the business, particularly as this is a marketing project. She has the authority to commit the annual business marketing budget, from which the project will be funded, as she sees appropriate. She will be responsible for monitoring the expected benefits of the calendar, in particular the improvement of the company's image.
Engineering Manager: He has been responsible for many engineering innovations in the company and is still as keen and energetic as the day he started. VVhilst he will not be part of the project team, his staff will feature in the photos for the promotional calendar.
Central Records: This group of five staff looks after all company records and document control. They now maintain all project files.
Bright Lights: This is the local office supplies company. It supplies all the stationery and office equipment needs of the company and will supply the stationery for this project.
Portraits ltd: This is a professional photographic company with a number of excellent photographers and a history of successful work. This company has been selected to take the photos for the company calendar. It has yet be decided which of the photographers to use.
Which 2 statements explain why the CEO should be appointed as the Executive for this project?

  • A. He started the company 25 years ago.
  • B. He knows his job very well.
  • C. He restricts his visits to the engineering area.
  • D. He has the authority to commit resources as required.
  • E. He has an overall perspective of the business's strategic requirements.

Answer: DE

NEW QUESTION 2

Scenario:
Techniques, processes and procedures
1. Any threat that may result in a loss of MFH data must be escalated immediately.
Joint agreements
2. Work is to start at the beginning of week 2 (Stage 4).
3. The project will take two years to complete, at an estimated cost of £2.5m. Tolerances
4. None.
Constraints
5. MFH staff must not be involved in any heavy lifting during the removal of existing IT equipment.
6. Installation work must take place during MFH normal working hours. 7. +£10,000 / -£25,000.
Reporting arrangements
8. Highlight Report every Monday by 10.00 am.
9. The report must contain a summary of all products worked on during the previous week.
10. Project Manager must be notified of any issues immediately by telephone.
Problem handling and escalation
11. Impact analysis of all issues must be completed within 24 hours.
Extracts or references
12. The Stage Plan for stage 4 is available from Project Support.
Approval method
13. Project Assurance will review the completed Work Package and confirm completion.
Which 2 statements apply to either the Development Interfaces or Operations and maintenance interfaces sections?

  • A. Delete entry 2 because this interface will be contained in the Communication Management Strategy.
  • B. Delete entry 3 because this interface will be contained in the project control section of the Project Initiation Documentation.
  • C. Amend entry 4 to 'The transferred products relating to the services provided by the Facilities Division'.
  • D. Add 'Project Board, with responsibility for communicating progress to corporate management' to
  • E. Operations and maintenance Interfaces.
  • F. Add 'Facilities Team Manager, with responsibility for the transfer of services provided by the Facilities Division' to Development Interfaces.

Answer: DF

NEW QUESTION 3
HOTSPOT
Additional Information

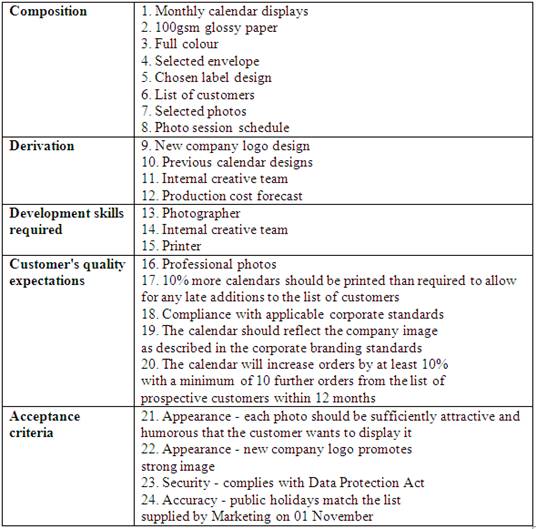

Prince2-Practitioner dumps exhibit
Further information on some resources who could be involved in the project: Outcome Account Manager: He represents Outcome which is a recruitment agency that
provides specialist outsourcing resources. Outcome provided the consultants who carried out the feasibility study and the same consultants will be providing support and guidance to the Information Technology and Facilities teams during the project.
Director of Finance Division: She was transferred from the Information Technology Division 12 months ago. She is responsible for ensuring a cost-conscious approach is adopted in all operational and project activities across the Ministry of Food Hygiene.
Hardware Manager: Reports to the Director of Information Technology. He provides computer hardware to all business functions but has little awareness of the needs of his colleagues working in software.
Payroll Manager: Reports to the Director of Finance. He is a very experienced and efficient qualified accountant who has much of the responsibility of running the Finance Division on behalf of the Director of Finance. He has been involved in drafting the Ministry's business strategy and assisting in a full business risk assessment. He also drafted the corporate Business Case standards.

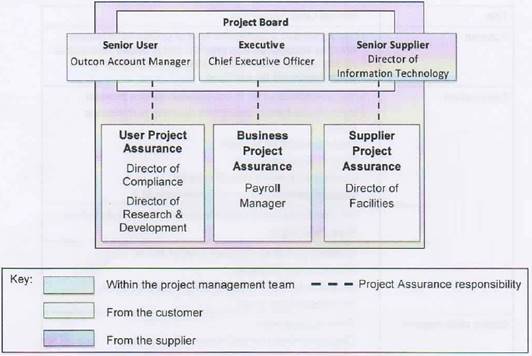

Using the Project Scenario and the additional information provided for this question in the Scenario Booklet, answer the following question about roles on the Outsourcing project.
Prince2-Practitioner dumps exhibit

  • A. Mastered
  • B. Not Mastered

Answer: A

Explanation:
Prince2-Practitioner dumps exhibit

NEW QUESTION 4

Which other management product is created when the Business case is updated during Initiating a Project?

  • A. Post project review plan
  • B. Risk Register
  • C. Benefits Review plan
  • D. Issue Register

Answer: C

NEW QUESTION 5
HOTSPOT
Scenario
A central government department, the Ministry of Food Hygiene (MFH), faces increasing pressure to cut costs, better manage suppliers’ performance and reduce the confusion
caused by inadequate internal controls, outdated standards and outdated technology. External consultants were employed to conduct a feasibility study to identify options to address the problems, and the likely costs and benefits. The following options were considered:
Do nothing.
Re-engineer selected business functions. Outsource selected business functions.
The feasibility study concluded that there was a case for outsourcing the MFH Information Technology
Division and the Facilities Division (maintenance of buildings and grounds). The recommendations were:
One service provider should be contracted to provide the services currently provided by the
Information Technology Division and the Facilities Division.
A 10-year service contract should be agreed with the selected service provider.
The feasibility study developed high-level designs of the current organization, processes, systems and
operating models, plus an outline Business Case for the required project. The external consultants
also made the following recommendations for the management of the project:
Use PRINCE2.
Set up the project with 4 management stages:
Stage 1. Standard PRINCE2 initiation activities.
Stage 2. Create detailed designs (future organization, processes, systems and operating models) and the service level agreement between MFH and the future service
provider.
Stage 3. Request and evaluate proposals, select service provider and agree contract. Stage 4. Transfer equipment and staff, transfer responsibility for service provision and run trial period.
Initial estimates indicated that the project would cost £2.5m and take two years to complete.
MFH senior management agreed that there was a case for outsourcing, and accepted the recommendations as a basis for the project. There is an expected saving of £20m over 10 years.
The Outsourcing project has completed the Starting up a Project process and is now in the initiation stage. Because of the strategic importance of the project, the MFH Chief Executive Officer has taken the role of Executive. A PRINCE2-experienced Project Manager has been appointed from within MFH. Staff within the business functions being outsourced will work with the external consultants who conducted the feasibility study to define the detailed designs.

Lines 1 to 6 in the table below consist of an assertion statement and a reason statement. For each line identify the appropriate option, from options A to E, that applies. Each option can be used once, more than once or not at all.
Prince2-Practitioner dumps exhibit

  • A. Mastered
  • B. Not Mastered

Answer: A

Explanation:
Prince2-Practitioner dumps exhibit

NEW QUESTION 6
HOTSPOT
Scenario:
Techniques, processes and procedures
1. Any threat that may result in a loss of MFH data must be escalated immediately.
Joint agreements
2. Work is to start at the beginning of week 2 (Stage 4).
3. The project will take two years to complete, at an estimated cost of £2.5m. Tolerances
4. None.
Constraints
5. MFH staff must not be involved in any heavy lifting during the removal of existing IT equipment.
6. Installation work must take place during MFH normal working hours. 7. +£10,000 / -£25,000.
Reporting arrangements
8. Highlight Report every Monday by 10.00 am.
9. The report must contain a summary of all products worked on during the previous week.
10. Project Manager must be notified of any issues immediately by telephone.
Problem handling and escalation
11. Impact analysis of all issues must be completed within 24 hours.
Extracts or references
12. The Stage Plan for stage 4 is available from Project Support.
Approval method
13. Project Assurance will review the completed Work Package and confirm completion

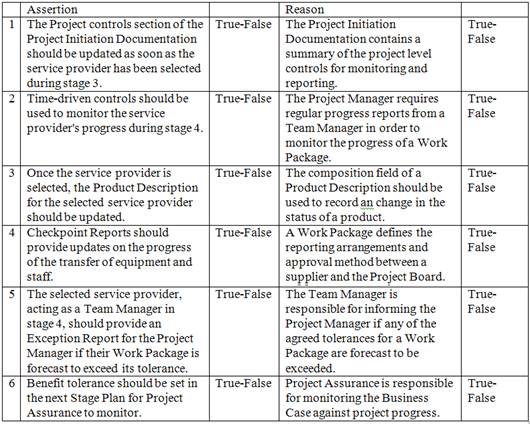

At the end of stage 3, the service provider will be selected and the contract awarded. During stage 4, the Account Manager for the selected service provider will work with the Project Manager to complete the transition of the services to the selected service provider.
Prince2-Practitioner dumps exhibit

  • A. Mastered
  • B. Not Mastered

Answer: A

Explanation:
Prince2-Practitioner dumps exhibit

NEW QUESTION 7

Additional Information
Prince2-Practitioner dumps exhibit
Further information on some resources who could be involved in the project: Outcome Account Manager: He represents Outcome which is a recruitment agency that
provides specialist outsourcing resources. Outcome provided the consultants who carried out the feasibility study and the same consultants will be providing support and guidance to the Information Technology and Facilities teams during the project.
Director of Finance Division: She was transferred from the Information Technology Division 12 months ago. She is responsible for ensuring a cost-conscious approach is adopted in all operational and project activities across the Ministry of Food Hygiene.
Hardware Manager: Reports to the Director of Information Technology. He provides computer hardware to all business functions but has little awareness of the needs of his colleagues working in software.
Payroll Manager: Reports to the Director of Finance. He is a very experienced and efficient qualified accountant who has much of the responsibility of running the Finance Division on behalf of the Director of Finance. He has been involved in drafting the Ministry's business strategy and assisting in a full business risk assessment. He also drafted the corporate Business Case standards.
Which 2 alternative actions apply to the proposed supplier assurance for this project?

  • A. Retain because he has a professional facilities qualification and so is in a position to specify the needs of his division.
  • B. Retain because he will be able to advise on many of the products that will enable outsourcing to happen, such as the 10-year outsourcing service contract.
  • C. Retain because he is well-regarded within the Ministry because of the efficiencies, superb service and savings he has achieved in the Facilities Division.
  • D. Add 'Outcome Account Manager' because he will advise on potential changes and their impact on the integrity of the project's products.
  • E. Remove because he is involved with the project and is therefore NOT independent.

Answer: BD

NEW QUESTION 8

Additional Information
Chief Executive Officer (CEO): He started the company 25 years ago and knows his job very well. He injured his leg two years ago which has restricted his visits to the engineering area. As CEO he has an overall perspective of the business strategic requirements and the authority to commit resources as required.
Marketing Director: She has been with the company for three years, following a successful career with a publicity company. She has the ability to represent the needs of the business, particularly as this is a marketing project. She has the authority to commit the annual business marketing budget, from which the project will be funded, as she sees appropriate. She will be responsible for monitoring the expected benefits of the calendar, in particular the improvement of the company's image.
Engineering Manager: He has been responsible for many engineering innovations in the company and is still as keen and energetic as the day he started. VVhilst he will not be part of the project team, his staff will feature in the photos for the promotional calendar.
Central Records: This group of five staff looks after all company records and document control. They now maintain all project files.
Bright Lights: This is the local office supplies company. It supplies all the stationery and office equipment needs of the company and will supply the stationery for this project.
Portraits ltd: This is a professional photographic company with a number of excellent photographers and a history of successful work. This company has been selected to take the photos for the company calendar. It has yet be decided which of the photographers to use.
Which 2 statements explain why Central Records should be appointed as Project Support for this project?

  • A. They control the receipt, identification, versions, storage and issue of all project products within the company's projects.
  • B. They already exist within the organization and have been with the company for many years.
  • C. They will ensure compliance with all company policies and procedures.
  • D. They perform a quality assurance function across all projects.
  • E. They have knowledge of the organizational standards that will be applicable to the project.

Answer: AE

NEW QUESTION 9

It is now late October and the project is in stage 3. The label design competition has been held and the photos of the staff have been taken. The CEO and Marketing Director still need to choose the winning label design and the 12 photos for the calendar. However, the Executive has learned that two competitors are issuing calendars to MNO's customers by the middle of November. After analyzing the impact of this Issue, one of the options the Project Manager has presented to the Project Board is to close the project prematurely.
There are a number of key facts relating to this project that would need to be recorded if the project Y-e to be closed now.
Which product should show that the project has been closed prematurely and has not achieved the objectives defined in the Project Initiation Documentation (PID)?

  • A. Benefits Review Plan
  • B. End Project Report
  • C. Exception Report
  • D. Project closure notification

Answer: B

NEW QUESTION 10

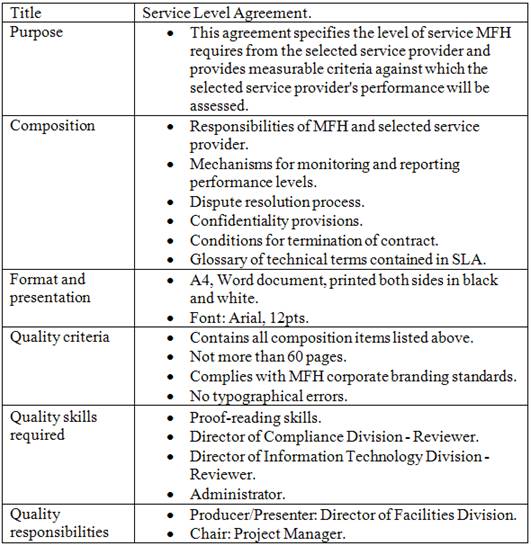

Additional Information Product Description
Prince2-Practitioner dumps exhibit
Quality notes from the Daily Log
The Director of Information Technology Division (DIT) has been asked to ensure that any changes to the outsourced staff employment contracts adhere to employment law. The DIT
will review future job descriptions of the transferred staff before the final contract is signed with the selected service provider.
The service level agreement between MFH and the selected service provider will specify the type and quality of service required. The selected service provider must follow the industry standards for providing outsourced services.
MFH has a quality management system which contains a document control procedure for all its documentation, however this does not include change management.
All project documents will be subject to a quality review. Nominated products will require a formal approval record signed-off by the quality review chair.
Extract from the draft Quality Management Strategy (may contain errors) Introduction
1. This document defines the approach to be taken to achieve the required quality levels during the project.
2. The Project Board will have overall responsibility for the Quality Management Strategy.
3. Project Assurance will provide assurance on the implementation of the Quality Management Strategy.
Quality management procedure - Quality standards
4. The selected service provider will operate to industry standards for providing outsourced services.
5. MFH document standards will be used.
Records
6. A Quality Register will be maintained to record the planned quality events and the actual results from the quality activities.
7. Configuration Item Records will be maintained for each product to describe its status, version and variant.
8. Approval records for products that require them will be stored in the quality database. Roles and responsibilities
9. The DIT will check that the employment contracts for outsourced staff adhere to employment law.
10. Team Managers will provide details of quality checks that have been carried out.
11. Team Managers will ensure that the Quality Register is updated with the names of team members who are involved in the review process.
12. The Senior User will review the Product Descriptions of the products to be produced by the selected service provider to ensure that they can be achieved.
The service level agreement contains a number of technical terms that are missing from its glossary of terms.

  • A. Obtain agreement from the Director of Facilities Division to add these into the glossary of terms within the remaining +2 days tolerance.
  • B. Raise an issue (off-specification).
  • C. Raise an issue (request for change).
  • D. No action required.

Answer: A

NEW QUESTION 11

During stage 1 the level of performance expected from the service provider was changed. After this change was agreed which of these products will require updating?

  • A. Project Brief because this is maintained throughout the project to reflect the customer's quality expectations.
  • B. Project Product Description because this contains details of the expected performance of the project's products.
  • C. Quality Management Strategy because this is where all of the customer's quality expectations of the project's products should be documented.

Answer: B

NEW QUESTION 12
HOTSPOT
Scenario
A photographer from Portraits Ltd, a professional photographic company, has taken on the role of Team Manager after taking some time to understand the requirements of the project. A contract for their services has been set up and is being monitored by the Purchasing Manager and a Work Package has been agreed. This contract specifies that the photographer must arrange a meeting with the Engineering Manager to establish a schedule for the photo sessions to minimize the impact on the Engineering staff. This meeting should have occurred by now.
The Engineering Manager was made aware of this requirement but when asked he reported that he has received no communication from the photographer. The Project Manager has tried to call the photographer and has had no response. The Project Manager believes there is a risk that Portraits Ltd are overbooking work and prioritizing other clients' work. If Portraits ltd do not deliver on schedule the project will be delayed and the expected benefits will be reduced.
The contract is to be reviewed and Portraits Ltd reminded of their agreement.
The project is now in stage 2. The Project Manager has heard about the possibility of a competitor also producing a calendar to be delivered earlier than the target date for this project. There is a threat that the early release of a competitor's calendar may weaken the impact of the MNO Manufacturing Company calendar, thereby reducing the anticipated benefits of the Calendar project.
Column 1 contains a number of risk responses identified by the Project Manager following an assessment of this risk. Column 2 contains a list of threat response types. For each risk response in Column 1, select from Column 2 the type of response it represents. Each option from Column 2 can be used once, more than once or not at all.

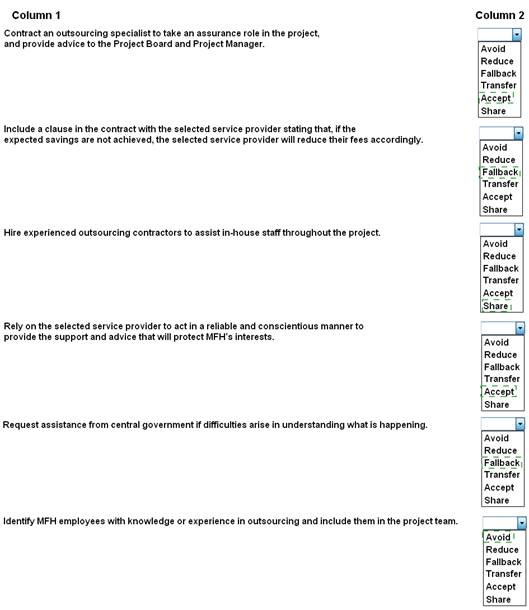

Column 1 contains a number of possible risk responses to the above risk. For each risk response, select from Column 2 the appropriate risk threat response type that it represents. Each selection from Column 2 can be used once, more than once or not at all.
Prince2-Practitioner dumps exhibit
Prince2-Practitioner dumps exhibit

  • A. Mastered
  • B. Not Mastered

Answer: A

Explanation:
Prince2-Practitioner dumps exhibit

NEW QUESTION 13

Product based planning focuses on which of the following:
1. Creating product descriptions
2. Identifying activities
3. Creating a Product hierarchy
4. Creating a Product sequence

  • A. 1, 2, 3
  • B. 2, 3, 4
  • C. 1, 3, 4
  • D. 1, 2, 4

Answer: A

NEW QUESTION 14

Which management product defines the detailed nature, purpose and function of a product?

  • A. Plan
  • B. Quality Register
  • C. Project Product Description
  • D. Product Description

Answer: D

NEW QUESTION 15

Which statement is an appropriate entry for the Initiation Stage Plan?

  • A. The Daily Log has been updated with the new risks which were identified while preparing the Initiation Stage Plan.
  • B. The plan is based on the external outsourcing consultants being available at the start of the initiation stage.
  • C. The initial project cost estimate of £2.5m, will have a tolerance of +£125k J•£75k.
  • D. The project management team will consist of representatives from the IT and Facilities Divisions.

Answer: B

NEW QUESTION 16

Scenario
A central government department, the Ministry of Food Hygiene (MFH), faces increasing pressure to cut costs, better manage suppliers’ performance and reduce the confusion caused by inadequate internal controls, outdated standards and outdated technology. External consultants were employed to conduct a feasibility study to identify options to address the problems, and the likely costs and benefits. The following options were considered:
Do nothing.
Re-engineer selected business functions. Outsource selected business functions.
The feasibility study concluded that there was a case for outsourcing the MFH Information Technology
Division and the Facilities Division (maintenance of buildings and grounds). The recommendations were:
One service provider should be contracted to provide the services currently provided by the
Information Technology Division and the Facilities Division.
A 10-year service contract should be agreed with the selected service provider.
The feasibility study developed high-level designs of the current organization, processes, systems and
operating models, plus an outline Business Case for the required project. The external consultants
also made the following recommendations for the management of the project:
Use PRINCE2.
Set up the project with 4 management stages:
Stage 1. Standard PRINCE2 initiation activities.
Stage 2. Create detailed designs (future organization, processes, systems and operating models) and the service level agreement between MFH and the future service
provider.
Stage 3. Request and evaluate proposals, select service provider and agree contract. Stage 4. Transfer equipment and staff, transfer responsibility for service provision and run trial period.
Initial estimates indicated that the project would cost £2.5m and take two years to complete.
MFH senior management agreed that there was a case for outsourcing, and accepted the recommendations as a basis for the project. There is an expected saving of £20m over 10
years.
The Outsourcing project has completed the Starting up a Project process and is now in the initiation stage. Because of the strategic importance of the project, the MFH Chief Executive Officer has taken the role of Executive. A PRINCE2-experienced Project Manager has been appointed from within MFH. Staff within the business functions being outsourced will work with the external consultants who conducted the feasibility study to define the detailed designs.
Which 2 statements should be recorded under the Expected dis-benefits heading?

  • A. An investment of £2.5m is required.
  • B. Staff morale will be negatively affected.
  • C. The project will take two years to deliver.
  • D. Staff may lose the opportunity to work in Information Technology.
  • E. MFH will lose direct control over the outsourced business functions.

Answer: CE

NEW QUESTION 17

Which of the following statements is NOT correct?
The Learn from Experience principle suggests that lessons should be actively sought...

  • A. When Starting a Project
  • B. When Initiating a Project
  • C. As the project progresses
  • D. As the project closes

Answer: B

NEW QUESTION 18

Scenario
A central government department, the Ministry of Food Hygiene (MFH), faces increasing pressure to cut costs, better manage suppliers’ performance and reduce the confusion caused by inadequate internal controls, outdated standards and outdated technology. External consultants were employed to conduct a feasibility study to identify options to address the problems, and the likely costs and benefits. The following options were considered:
Do nothing.
Re-engineer selected business functions. Outsource selected business functions.
The feasibility study concluded that there was a case for outsourcing the MFH Information Technology
Division and the Facilities Division (maintenance of buildings and grounds). The recommendations were:
One service provider should be contracted to provide the services currently provided by the
Information Technology Division and the Facilities Division.
A 10-year service contract should be agreed with the selected service provider.
The feasibility study developed high-level designs of the current organization, processes, systems and
operating models, plus an outline Business Case for the required project. The external consultants
also made the following recommendations for the management of the project:
Use PRINCE2.
Set up the project with 4 management stages:
Stage 1. Standard PRINCE2 initiation activities.
Stage 2. Create detailed designs (future organization, processes, systems and operating models) and the service level agreement between MFH and the future service
provider.
Stage 3. Request and evaluate proposals, select service provider and agree contract. Stage 4. Transfer equipment and staff, transfer responsibility for service provision and run trial period.
Initial estimates indicated that the project would cost £2.5m and take two years to complete.
MFH senior management agreed that there was a case for outsourcing, and accepted the recommendations as a basis for the project. There is an expected saving of £20m over 10
years.
The Outsourcing project has completed the Starting up a Project process and is now in the initiation stage. Because of the strategic importance of the project, the MFH Chief Executive Officer has taken the role of Executive. A PRINCE2-experienced Project Manager has been appointed from within MFH. Staff within the business functions being outsourced will work with the external consultants who conducted the feasibility study to define the detailed designs.
Which 2 statements should be recorded under the Business options heading?

  • A. The re-engineering of selected business functions would not provide the required outcome.
  • B. The lack of up-to-date technology in MFH means a re-engineering of existing services will not necessarily deliver the performance improvements required.
  • C. Use external consultants to provide guidance on the detailed design of the outsourced services.
  • D. Set up a PRINCE2 project to deliver the outsourced services.
  • E. Review a list of service providers to determine a short-list of possible service providers.

Answer: CD

NEW QUESTION 19

Scenario:
The Ministry of Food Hygiene (MFH) has a quality management system which contains a document control process to manage all documentation requirements. The document control process was created by the MFH Quality Manager, who now maintains all of MFH's documents and performs an organization-wide configuration management role. The MFH Quality Manager will administer the configuration management procedure for the Restructuring project since this must comply with the MFH document control process.
Having created the Issue Report and analyzed the impact of removing the Facilities Division from the scope of the Outsourcing project, the proposed option exceeds tolerance.
\Nhat is the next action the Project Manager should consider?

  • A. Create an Exception Report to inform the Project Board of the situation and the available options.
  • B. Update the associated Configuration Item Records with details of the Issue Report that caused the change.
  • C. Amend the Stage Plan for stage 3: remove all products related to the Facilities Division and add the activities required to deliver the new Government initiative.
  • D. Create an Exception Plan to change all of the project's products to reflect the exclusion of services provided by the Facilities Division.

Answer: A

NEW QUESTION 20

Project Scenario
Calendar Project (Note: The companies and people within the scenario are fictional.)
There has been a reduction in fie number of orders at the MNO Manufacturing Company due in part to the increased marketing activities of its competitors. To help counter this, the company has decided to create a promotional calendar for next year for all its current and prospective customers. The end product of this project will be a prepared calendar pack, ready for printing. The design of the calendar will be similar to one sent out previously, and must reflect the company image as described in the existing corporate branding standards. Another project is currently producing a new company logo when is to be printed on each page of the promotional calendar. The prepared calendar pack will consist of:
✑ Design for each month - correctly showing at public holidays and new company logo
✑ Selected photographs- 12 professionally-produced photographs, showing different
members of staff
✑ Selected paper and selected envelope - for printing and mailing the calendar
✑ Chosen label design - a competition to design a label will be held as part of this project
✑ List of customers - names and addresses of customers to whom the calendar will be sent.
The project is currently in initiation and will have two further stages:
Stage 2 will include tie activities to:
✑ Create the customer fast using information from the Accounts and Marketing departments
✑ Confirm compliance with the Data Protection Legislation
✑ Create a design for each month - this will be done by the internal creative team
✑ Select and appoint a professional photographer
✑ Gather photograph design ideas from previous project and agree photographic session schedule
✑ Prepare a production cost forecast
✑ Select paper and envelope.
Stage 3 will include the activities to:
✑ Produce and select tie professionally-taken photographs
✑ Hold the label design competition and choose the label design
✑ Assemble the prepared calendar pack.
A production cost forecast, based on the options and costs for the paper, envelope, printing and marketing of the calendar is to be produced in stage 2. However, the actual production and distribution of the calendars is not within the scope of the project. The product cost forecast will be reviewed by the Project Board to determine whether tie project should continue.
It is now 05 October and the prepared calendar pack must be delivered to the print company by 30 November, to enable printing and distribution of the calendar in time for Christmas. The cost of the activities to develop the specialist products and the cost of the project management activities are estimated to be £20,000. There is a project time tolerance of +1 week /-2 weeks and a project cost tolerance of +£6,000 / -£6,000. A change budget of £500 has been allocated but there is no risk budget.
At the end of initiation there is +1 week 1-2 weeks time tolerance for this project. Which statement is true?

  • A. There can be no time tolerances for any of the stages.
  • B. All of the project level time tolerance can be allocated to stage 2.
  • C. The Stage Plan for stage 2 could create some additional project time tolerance by allowing no time tolerance in Team Plans.
  • D. Additional time tolerance for the project could be found by adding extra resources without affecting other tolerances.

Answer: B

NEW QUESTION 21

M1ich statement is an appropriate entry for the outline Business Case heading within the Project Brief?

  • A. 10 year service contract should be agreed with the selected service provider.
  • B. External consultants were employed to conduct a feasibility study to identify the options, their likely costs and benefits.
  • C. The project will run for two years and the benefits will be realized over 1a years.
  • D. The project should be split into four management stages.

Answer: C

NEW QUESTION 22

Additional Information Product Description
Prince2-Practitioner dumps exhibit
Quality notes from the Daily Log
The Director of Information Technology Division (DIT) has been asked to ensure that any changes to the outsourced staff employment contracts adhere to employment law. The DIT will review future job descriptions of the transferred staff before the final contract is signed with the selected service provider.
The service level agreement between MFH and the selected service provider will specify the type and quality of service required. The selected service provider must follow the industry standards for providing outsourced services.
MFH has a quality management system which contains a document control procedure for all its documentation, however this does not include change management.
All project documents will be subject to a quality review. Nominated products will require a formal approval record signed-off by the quality review chair.
Extract from the draft Quality Management Strategy (may contain errors) Introduction
1. This document defines the approach to be taken to achieve the required quality levels during the project.
2. The Project Board will have overall responsibility for the Quality Management Strategy.
3. Project Assurance will provide assurance on the implementation of the Quality Management Strategy.
Quality management procedure - Quality standards
4. The selected service provider will operate to industry standards for providing outsourced services.
5. MFH document standards will be used.
Records
6. A Quality Register will be maintained to record the planned quality events and the actual results from the quality activities.
7. Configuration Item Records will be maintained for each product to describe its status, version and variant.
8. Approval records for products that require them will be stored in the quality database. Roles and responsibilities
9. The DIT will check that the employment contracts for outsourced staff adhere to employment law.
10. Team Managers will provide details of quality checks that have been carried out.
11. Team Managers will ensure that the Quality Register is updated with the names of team members who are involved in the review process.
12. The Senior User will review the Product Descriptions of the products to be produced by the selected service provider to ensure that they can be achieved.
Which is a correctly defined acceptance criterion for the running cost of the outsourced service?

  • A. Must be kept to a minimum.
  • B. Must be kept to a level acceptable to the Ministry of Food Hygiene.
  • C. Subject to market conditions.
  • D. The annual increase to be less than half the rate of inflation.

Answer: D

NEW QUESTION 23

When examining a project issue, which three aspects should be considered?
1. Performance targets
2. Business Case
3. Resources
4. Risk

  • A. 1, 3, 4
  • B. 2, 3, 4
  • C. 1, 2, 4
  • D. 1, 2, 3

Answer: C

NEW QUESTION 24

Extract from the Project Product Description (with errors)
Prince2-Practitioner dumps exhibit
Which 2 statements apply to the Composition section?

  • A. Amend entry 2 to 'Selected paper'.
  • B. Delete entry 3 because this is NOT a major product to be delivered by this project.
  • C. Move entry 6 to Derivation because this product already exists.
  • D. Delete entry 7 because these will be produced by the photographer.
  • E. Add 'Calendars distributed to customers'.

Answer: AB
